Rural Manitoba LongHaul & Distribution Build
2021–2025 | Rural Manitoba Long Haul & Distribution Build
No Limits Underground delivered one of the largest rural broadband civil builds in Manitoba, completing more than 1,200 km of longhaul and distribution mainline construction across numerous municipalities between 2021 and 2025. This multiyear initiative brought highspeed connectivity to thousands of rural homes and businesses through a full civil and fiber installation scope.
Project Overview

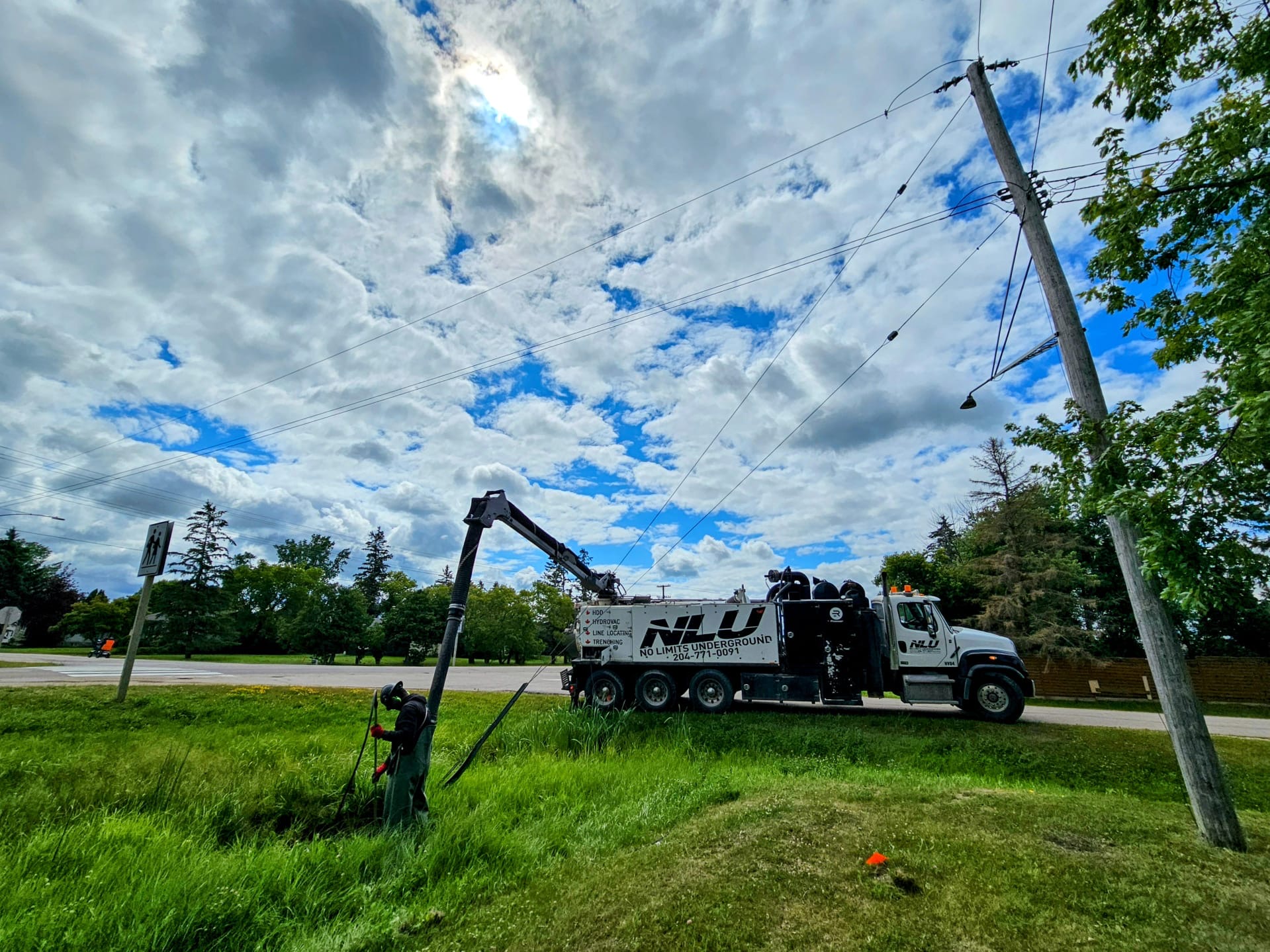

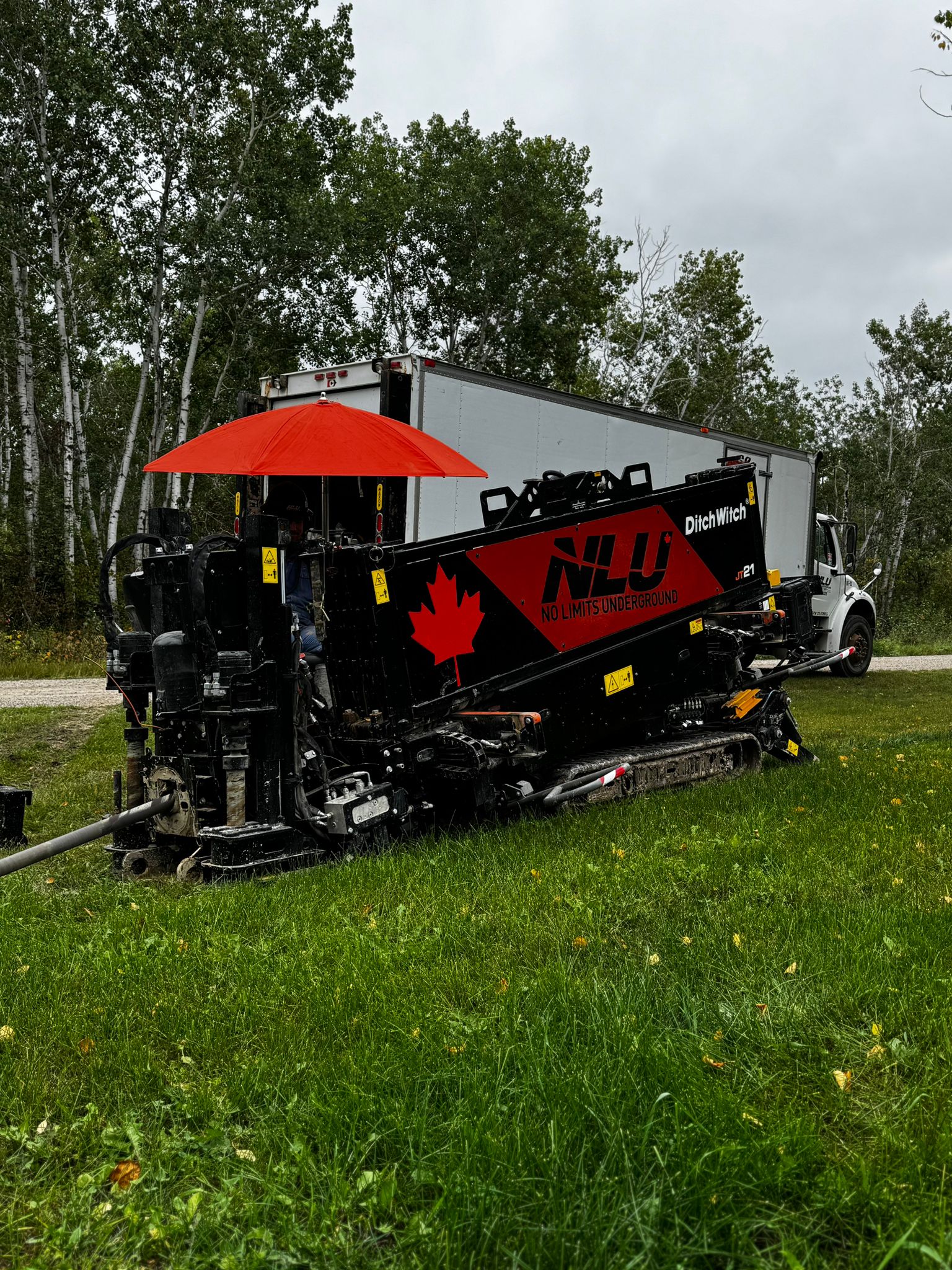

Our team executed the complete civil build—directional drilling, trenching, plowing, backhaul routes, distribution networks, service drops, fiber placement, and splicing. With the exception of engineering and design, NLU delivered every component of the construction program.
The project required rapid scaling of workforce and equipment. We expanded our fleet, added specialized machinery, and grew our team to meet aggressive timelines and evolving project demands. Throughout the build, we collaborated closely with planning teams and permit holders to resolve alignment issues, optimize routes, and develop solutions for complex crossings.
Key Challenges
The project spanned diverse and often difficult terrain, including:
- Canadian Shield conditions, limestone, and bedrock
- Wetlands, low‑lying areas, and environmentally sensitive zones
- Dense forest and bush corridors
- Tight deadlines across multiple municipalities
- Winter construction and extreme weather
- Numerous major crossings requiring specialized planning
Despite these challenges, NLU consistently met schedule expectations and maintained high construction standards across all phases.
Major Crossings Completed
The long‑haul routes required extensive coordination and execution of significant crossings, including:
- Major waterways and river systems
- Railway corridors
- Provincial and national highways
- Aqueduct infrastructure
- TransCanada pipeline corridors
Each crossing was completed safely, efficiently, and in full compliance with regulatory requirements.
Project Scope by Region
RM of Stanley – Fall 2021
• 25.4 km of backhaul & mainline
• 75+ homes serviced
RM of Dufferin – Winter 2021/2022
• 48 km of backhaul & mainline
• 100+ homes serviced
RM of Roland – Winter/Spring 2022
• 8.2 km of backhaul & mainline
• Fiber placement & splicing
• 10 homes serviced
RM of Morris – Winter/Spring 2022
• 14.2 km of backhaul & mainline
• 50 homes serviced
RM of Rhineland – Spring 2022
• 36.5 km of backhaul & mainline
• 130 homes serviced
Altona East – Private Capital – Spring 2022
• 1.2 km of mainline
• 20 homes serviced
RM of Springfield – Summer 2022
• 531 km of backhaul & mainline
• 2,000+ homes serviced
East Selkirk – Private Capital – Winter 2022/2023
• 12 km of mainline drilling in harsh winter conditions
RM of St. Andrews – Winter 2022/2023
• 28.5 km of backhaul & mainline
RM of St. Clements – 2023–2025
• 171 km of backhaul & mainline
• 1,500+ homes serviced
Additional Rural Municipalities
• 157 km of completed backhaul & mainline
Total Completed Construction
Approx. 1,200 km of long‑haul and distribution fiber infrastructure since Fall 2021.
